ACP Construction Schedule

You are here: Home » ACP Construction Schedule

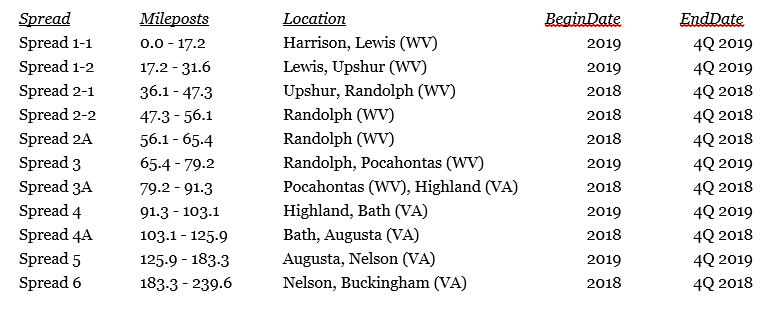

ABRA has prepared the table below indicating when construction on the Atlantic Coast Pipeline is scheduled to commence and end for those portions in West Virginia and Virginia (to the southern Buckingham County border). Each section, or spread, of the route is also detailed in a map that can be accessed here.

ACP Construction Schedule
Tagged on: ACP    Atlantic Coast Pipeline    construction    schedule
Daniel Shaffer February 9, 2018 Pipeline Updates
  • ← Furtive pipeline deal begs legal answers
  • Announcement of Registration for March 3 ABRA Pipeline CSI Meeting →

ABRA CONSERVATION HUB

ABRA’s Conservation Hub program promotes responsible resource management by providing access to critical information needed for effective public involvement in environmental review and oversight.

Following the defeat of the Atlantic Coast Pipeline in 2020, ABRA initiated the Conservation Hub to support informed public engagement with the broader range of environmental issues confronting the Allegheny-Blue Ridge Mountain region. The Conservation Hub builds on the analysis and information sharing capacity achieved through ABRA’s Pipeline CSI project during the years of ACP opposition.

The Conservation Hub is based on the use of GIS mapping to provide details and context for land development projects and management practices that involve risk of environmental harm, as well as for environmental preservation and restoration initiatives. The Conservation Hub also provides access to regulatory documents and assessments related to specific projects or issues.

Multiple Conservation Hub sites, focused on individual projects or issues, have been developed collaboratively with ABRA’s partners and allies. Going forward, we invite conservation groups, individuals, and communities to provide ideas for new Hub sites and GIS mapping that can contribute to informed public engagement on behalf of environmental integrity in the Allegheny-Blue Ridge region.

ABRA

The Allegheny-Blue Ridge Alliance is a 501(c)(3) non-profit organization dedicated to promoting and protecting the environmental integrity of the Allegheny-Blue Ridge region and the surrounding  Central Appalachian Highlands of Virginia and West Virginia.

Policies

Follow us

  • facebook

Contact Us

Dan Shaffer, Executive Director
Andrew Young, Staff Attorney

810 Parkview Ave.
Staunton, VA 24401

Support ABRA

DONATE HERE

Subscribe to ABRA Updates

Copyright © 2026 Allegheny-Blue Ridge Alliance. All rights reserved. Theme: Spacious by ThemeGrill. Powered by: WordPress
